PilotOne station installed in Cantigi; power data reached ThingsBoard (Dec 2022)Satu stasiun terpasang di Cantigi; data daya masuk ke ThingsBoard (Des 2022)
Charging Station Tracker
OverviewRingkasan
Solar charging station for fishermen's boat-lamp batteries in Cantigi, Indramayu, with an ESP32 power monitor. It measures solar input and charging output and sends the data to ThingsBoard.Stasiun pengisian tenaga surya untuk baterai lampu perahu nelayan di Cantigi, Indramayu, dilengkapi monitor daya ESP32. Mengukur input surya dan output pengisian, lalu mengirim datanya ke ThingsBoard.
My RolePeran Saya
ESP32 + PZEM-017 energy monitoring firmware, solar/battery system wiring, 4G uplink, ThingsBoard dashboard and installationFirmware monitoring energi ESP32 + PZEM-017, wiring sistem surya/baterai, uplink 4G, dashboard ThingsBoard, dan instalasi
How It WorksCara Kerja

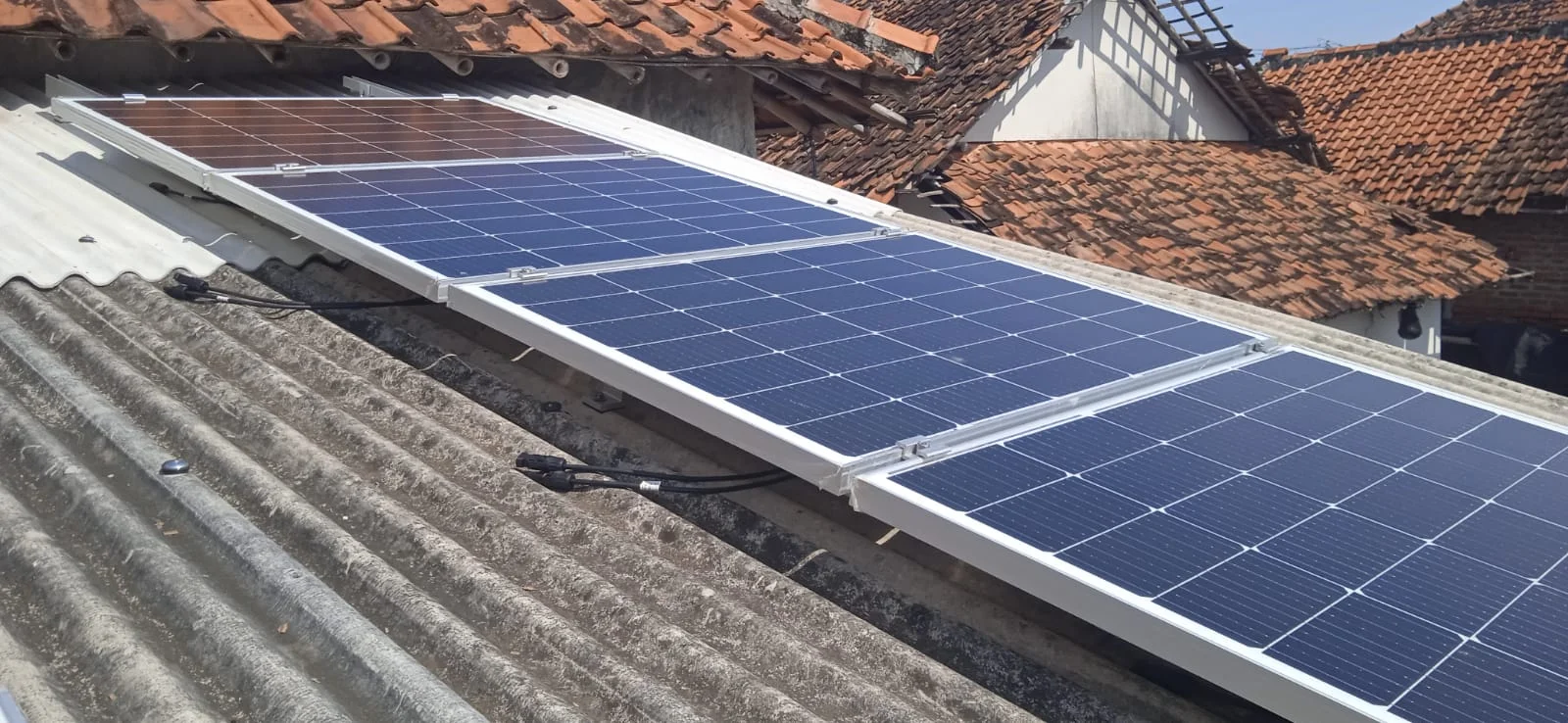

- 10 × 120 Wp panels → MPPT charge controller → main battery and fishermen's batteries10 × panel 120 Wp → MPPT charge controller → baterai utama dan baterai nelayan

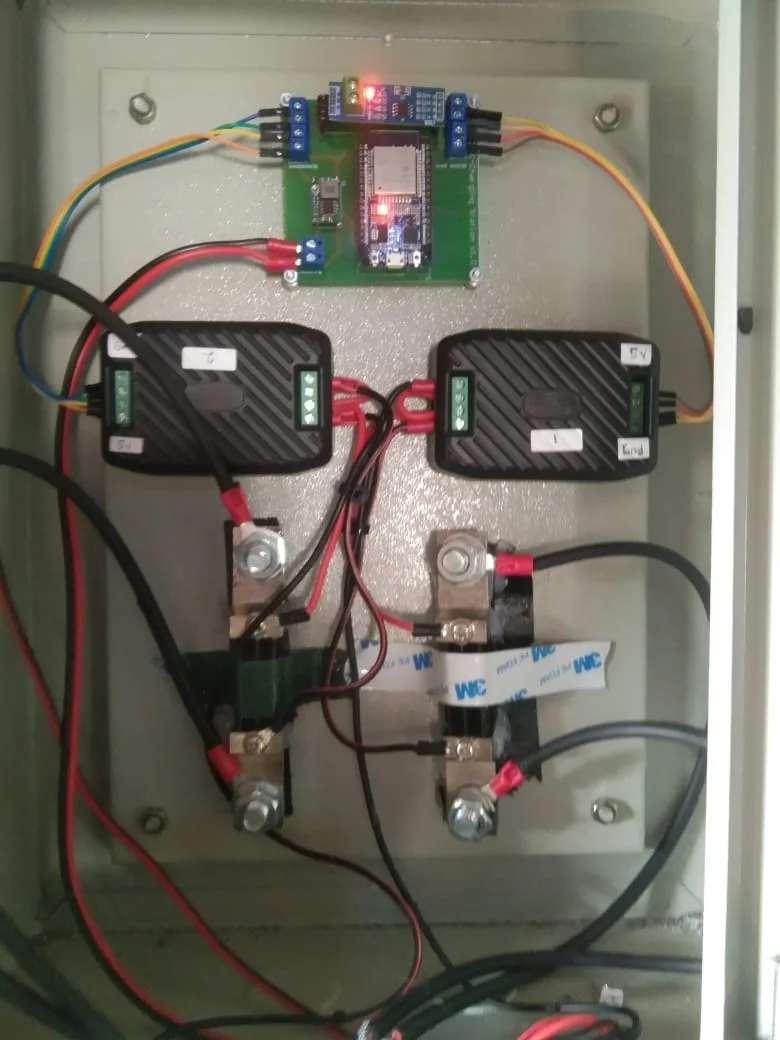

- PZEM-017 shunt meters on the panel and load sidesMeter shunt PZEM-017 di sisi panel dan beban
- ESP32 reads both meters over RS485ESP32 membaca kedua meter lewat RS485
- 4G Wi-Fi modem → MQTT → ThingsBoard → Living Lab platformModem WiFi 4G → MQTT → ThingsBoard → platform Living Lab
Key FeaturesFitur Utama
- •Solar-side and load-side voltage, current, power and energy measurementPengukuran tegangan, arus, daya, dan energi di sisi surya dan sisi beban
- •Readings every 5 s, published to ThingsBoard every 30 sPembacaan setiap 5 s, dipublikasikan ke ThingsBoard setiap 30 s
- •Publish topic and interval configurable remotely through ThingsBoard attributesTopic dan interval publish dapat dikonfigurasi dari jarak jauh melalui atribut ThingsBoard
- •Automatic Wi-Fi and MQTT reconnectionKoneksi ulang Wi-Fi dan MQTT otomatis
- •Terminal block for charging several fishermen's batteries at onceTerminal block untuk mengisi beberapa baterai nelayan sekaligus
Field Issues & FixesKendala & Solusi
The installation site changed during the project.Lokasi instalasi berubah di tengah proyek.

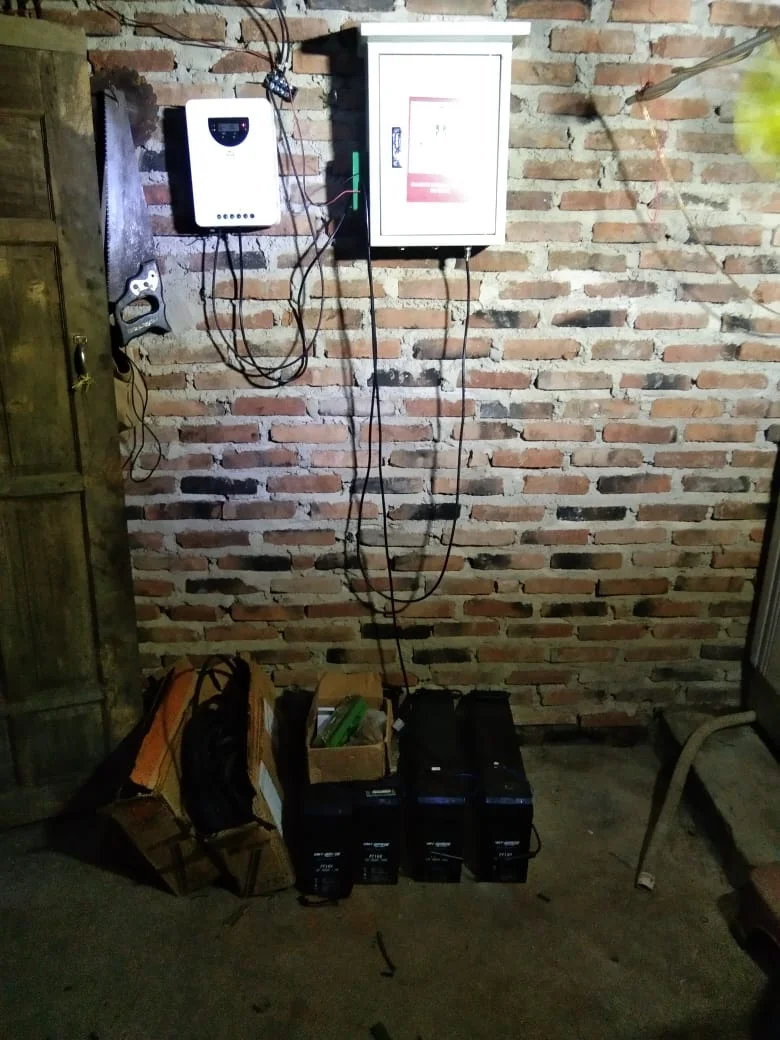

The station design was adapted to the new site; installation was done by the district (kecamatan) staff.Desain stasiun disesuaikan dengan lokasi baru; instalasi dilakukan oleh staf kecamatan.
Moving equipment from the district office to the installation site was difficult, and the build window after parts arrived was short.Memindahkan peralatan dari kantor kecamatan ke lokasi instalasi sulit, dan waktu perakitan setelah komponen datang sangat singkat.
Bench-tested the monitor with panels in sun and in shade before handing over for installation.Menguji monitor di bench dengan panel di bawah matahari dan di tempat teduh sebelum diserahkan untuk instalasi.
Key NumbersAngka Kunci
- Solar arrayArray surya
- 10 × 120 Wp (1.2 kWp)10 × 120 Wp (1,2 kWp)
- Design loadBeban desain
- 6,000 Wh/day for 10 boats6.000 Wh/hari untuk 10 perahu
- Reading / publish intervalInterval baca / kirim
- 5 s / 30 s5 dtk / 30 dtk
